How to Install Pea Gravel — Complete DIY Guide 2026

Verified against USDA NRCS Conservation Practice Standards and ASTM C33 aggregate gradation specifications · Methodology · Last updated May 2026

The physical work of putting down pea gravel takes a weekend. The prep work — the right depth, the right fabric for your soil, the right base — determines whether the surface lasts two years or twenty. Most guides get the prep wrong. This one covers it correctly.

Quick Answer: Excavate to depth. Lay 4oz landscape fabric (woven for sandy soil, non-woven for clay). Add crushed stone base in 2-inch compacted lifts. Install edging staked every 2 feet. Spread 3/8-inch washed pea gravel to depth. Rake level.

Correct Depth by Project Type

The steps for every pea gravel installation — walkway, patio, path, or garden bed — are the same. The depths change by project type. Set your targets before buying a single bag or calling a supplier.

Project typeExcavation depthBase layerGravel layerTotal depth
Decorative bed or border2–3 inNone needed1–2 in2–3 in
Garden path — light use4 in1–2 in crushed stone2 in4 in
Garden path — regular use5 in2 in crushed stone3 in5 in
Patio or seating area5–6 in2 in crushed stone3 in5–6 in
Driveway — passenger cars6–7 in4 in compacted base2–3 in6–7 in

Add 1 inch to any excavation figure to account for settling in the first season. For driveway installation with heavy vehicles, see the driveway guide — driveways need a more detailed treatment than this general guide covers.

Tools and Materials Checklist

ItemNeeded forNotes
Tape measure and stakesAll projectsMark area before ordering anything
String lineAll projectsStraight-edge guidance for excavation
Spray paint or garden hoseAll projectsMarking curves and shapes on ground
Flat-edge spadeAll projectsClean vertical excavation walls at edges
Round-point shovelAll projectsLoosening and moving soil
WheelbarrowAll projectsMoving base stone and gravel
Metal landscape rakeAll projectsSpreading and levelling both layers
Hand tamperPaths and small patiosCompacting base layer — ~$30 to buy
Plate compactorLarge patios and drivewaysRent for $65–85/day — essential for large areas
4oz landscape fabricAll projectsWoven for sandy/loam soil, non-woven for clay — see Step 4
6-inch landscape staplesAll projectsOne every 12–18 inches along seams and edges
Steel or composite edgingAll except decorative bedsInstall before gravel, not after
Edging stakesAll edged projectsOne stake every 2 feet
Crusher run base (#3 or crusher run)Paths, patios, drivewaysAngular — compacts solid. Not rounded pea gravel
3/8 inch washed pea gravelAll projectsSpecify washed — unwashed contains clay fines
Garden hose with mist settingAll projectsMoistening base before compaction, settling gravel after spreading

Step 1 — Calculate Quantities Before Ordering

Order the wrong amount and you either run short on the last section or spend an afternoon moving surplus to the back of the property. Calculate before you call the supplier.

For the gravel layer, use the coverage calculator at your chosen depth. For the base layer, run the same calculator at base depth — the formula is identical. Add 10% to both figures before ordering.

Worked example: 12×14 ft patio with 3-inch gravel and 2-inch base

Gravel: 12 × 14 × (3 ÷ 12) = 42 ft³ = 1.56 yd³ × 1.10 = 1.71 yd³ to order
Base: 12 × 14 × (2 ÷ 12) = 28 ft³ = 1.04 yd³ × 1.10 = 1.14 yd³ to order

For the full material cost at your supplier's price, use the cost calculator. For the exact bag count if you're buying bagged rather than bulk, use the bags calculator.

Delivery timing matters. Order base stone and pea gravel for the same weekend. Base stone arrives and gets spread on day one. Pea gravel arrives on day two after the base is compacted. A 3-ton pile left in a driveway for several days becomes a hazard and a neighbour complaint. Book both deliveries from the same supplier if possible and ask for base stone first.

Step 2 — Mark Layout and Plan Drainage

Spray paint or a garden hose both work for marking the area on the ground. For straight lines, use a taut string between stakes. For curves, a hose lets you test multiple shapes before committing — once the excavation starts, adjustments cost time.

Standard path widths: 2 feet minimum for single-file walking, 3 to 4 feet for two people side by side, 5 feet for wheelchair accessibility. Patios need at least 10×10 feet for two chairs and 12×14 feet for a table with four chairs. Measure your actual outdoor furniture on the lawn before deciding — the size that looks right on paper always feels small when the furniture arrives.

Before you pick up a spade, identify the drainage slope. The finished pea gravel surface needs a 1/4-inch drop per foot of run, directing water away from any structure. On a 12-foot-wide patio, that means the far edge sits 3 inches lower than the house side. Measure and mark this now. Setting it later is much harder.

Step 3 — Excavate and Assess the Ground

Excavation quality determines everything that follows. Three things matter:

Depth. Dig to the total required depth from the table above, plus 1 inch for settling. Use a flat-edge spade for the walls at the edges — clean vertical walls support the edging properly and keep the surface boundary sharp.

Slope. Grade the bottom of the excavation to match the drainage pitch you planned in Step 2. Flat-bottomed excavations hold water under the gravel. After heavy rain, that trapped water undermines the base layer from below and causes settling. Even 1/4 inch per foot prevents this entirely.

Subgrade condition. Remove all sod, roots, and organic material down to native soil. Look for soft spots — areas where the excavation floor gives when you step on it. Compact soft spots with a tamper, or fill with a thin layer of crusher run and compact before proceeding. A soft spot under a garden path becomes a depression within one season.

The excavated soil needs to go somewhere. A 12×14 patio at 5 inches deep removes roughly 8 to 9 cubic feet of material — a noticeable pile. Use it to fill low spots elsewhere in the yard, build raised bed walls, or arrange collection. Don't leave it next to the project where it will get accidentally walked back in.

Step 4 — Landscape Fabric: Woven vs Non-Woven

The most common question at this stage is what to put under pea gravel. Most installation guides say "use woven landscape fabric" or "use non-woven landscape fabric" without explaining the difference. Both instructions are right in the right situation. Here is the actual distinction:

Fabric typeConstructionTensile strengthWater drainageBest for
Woven polypropylene (4oz+)Interlaced slit-film strandsHigh — resists tearing under loadGood initially, may slow on clay over timeSandy and loam soils, high-traffic areas
Non-woven polypropylene (4oz+)Heat-bonded random fibresLower tensile strengthExcellent — fibres maintain flow even on clayClay soils, drainage-critical areas

On clay soil, non-woven fabric is the correct choice. Clay swells when wet and can push fine particles upward through woven fabric over several years. Non-woven fabric's randomly bonded fibre structure maintains drainage flow even as clay particles press against it.

On sandy and loam soil, woven fabric's higher tensile strength holds better under the repeated load of foot and vehicle traffic. The slightly lower drainage rate doesn't matter because sandy soil drains freely below the fabric anyway.

Fabric weight matters too. The 4oz minimum is non-negotiable for any project with foot traffic. Lighter fabrics tear under edging stakes, shift under base stone spreading, and degrade faster under UV exposure at edges. Cheap fabric costs more in the long run when it needs replacing.

Installing the fabric correctly

Lay fabric across the entire excavated area, running from edge to edge. Where two sheets meet, overlap by at least 12 inches — not butted together. Secure with 6-inch landscape staples every 12 to 18 inches along all seams and edges. Fold excess fabric up against the excavation walls. The edging stakes will capture it in Step 6, preventing the edges from pulling up over time.

One thing all competitors miss: fabric over clay soil belongs directly on the clay, not on a sand layer. Sand placed over clay creates what soil engineers call a perched water table — water passes through the gravel and fabric, hits the sand, but then cannot drain through the clay below fast enough, so it saturates the sand layer. The result is a soggy base that shifts and fails. Fabric directly on clay, then crushed stone base directly on fabric.

Step 5 — Spread and Compact the Base Layer

The base layer carries structural load for paths and patios. Spread it wrong and it settles under traffic regardless of how carefully you laid the gravel on top.

The rule that no competitor explains clearly: compact in 2-inch lifts, never all at once. Spreading 4 inches of crusher run and running a plate compactor over it once produces a surface crust over a loose interior. Under foot and vehicle traffic, that loose interior settles and creates ruts within one season despite the surface initially feeling solid. Two 2-inch compacted lifts produce genuine density throughout.

Wet each lift lightly with a garden hose mist before compacting. Slightly moist material compacts 30 percent denser than bone-dry material. Too much water turns it to mud — a light surface mist is all you need.

When to use a plate compactor vs hand tamper: A hand tamper works for paths under 50 square feet and decorative areas with no vehicle traffic. For anything larger, or anything that will take regular foot traffic, rent a plate compactor. The difference in compaction density is significant — a hand tamper produces adequate results for light-use paths and that is roughly its limit.

After compacting the final lift, the base should feel completely solid underfoot with no give. Walk across it in different directions. Any soft spot means incomplete compaction — go back over it before proceeding to edging.

Step 6 — Install Edging

Edging is not decorative. It is structural. A pea gravel path without perimeter containment scatters into the adjacent lawn within weeks of the first use regardless of how carefully the gravel was spread.

Steel edging is the most durable option for straight runs and gentle curves. It resists frost heave better than composite, holds its position under edging stakes, and lasts decades. Composite and recycled plastic edging work well for tighter curves and areas where the industrial look of metal is unwelcome. Timber edging — railway sleepers, pressure-treated timber — provides the most visual weight and works for formal bordered paths and patios.

Staking interval is critical. One stake every 2 feet. Every 3 feet leaves the edging flexible enough to bow outward under gravel pressure over time. Every 2 feet keeps it rigid.

Height setting is the most important measurement in the whole installation. The top of the edging must sit at exactly the finished surface height — base depth plus planned gravel depth. Edging set too low allows gravel to roll over it. Edging set too high creates a trip hazard and looks unfinished. Get this right before any gravel goes down.

Capture the folded fabric edges under the edging stakes as you install them. This prevents the fabric from pulling upward at the edges over time, which exposes it and allows gravel to work under it.

Step 7 — Spread Pea Gravel

Whether you call it how to lay pea gravel, how to put down pea gravel, or how to spread pea gravel — this final step is the same. Always order washed 3/8-inch pea gravel. Unwashed material contains clay fines that reduce drainage, compact poorly, and eventually create a muddy layer on the surface after rain. The price difference between washed and unwashed is small. The performance difference is significant.

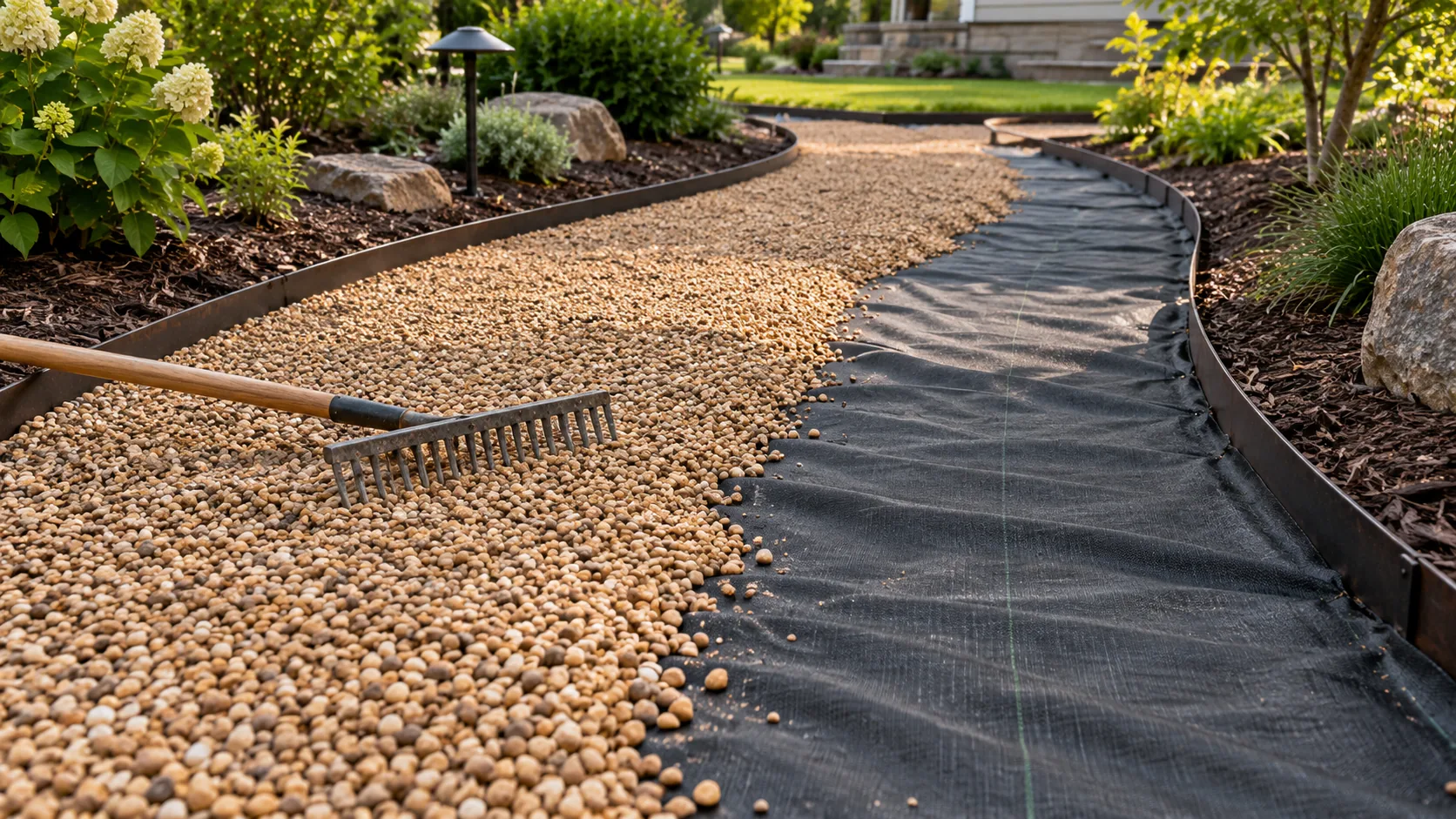

Dump the gravel in small piles across the area, then rake from pile to pile. Starting from one end and raking the entire surface tends to create an uneven finish — small piles distributed across the area give you better control of the final depth.

Do not compact pea gravel. The rounded stones do not compact like angular stone — compaction simply pushes them down into the base layer rather than locking them together. Raking pea gravel level is all the finishing required.

After raking pea gravel, use a straight-edge board across the edging to check that the surface sits 1/4 to 1/2 inch below the edging top. Gravel sitting at or above edging height scatters onto adjacent surfaces immediately. Gravel sitting more than 1/2 inch below edging height looks unfinished and creates a gap where debris accumulates.

Mist the surface lightly with a hose after spreading. This helps the stones settle into their final position and reveals any low spots that need a small additional spread. The surface will settle slightly further in the first season — plan a small top-up application 6 to 12 months after installation.

Special Situations

These pea gravel scenarios come up on real projects: slopes, existing concrete, existing gravel, backyard trees, and fence posts. Each needs a slightly different approach.

How to install pea gravel on a slope

On slopes up to 5 percent grade (3 degrees), install pea gravel normally with a proper base and edging. On slopes of 5 to 10 percent, add plastic honeycomb stabilization grids — geocells — before spreading gravel. The grids hold individual stones in cells that prevent directional migration downhill. On slopes above 10 percent, pea gravel is unsuitable as a surface. Switch to angular crusher run throughout.

To measure your slope: place a 4-foot level horizontally from the high end. Measure the gap between the level and the ground at the low end. Divide that gap in inches by 48, then multiply by 100 to get the percent grade. A 2.5-inch gap over 48 inches = 5.2 percent grade, which puts you in stabilization grid territory.

How to install pea gravel over concrete

Check first that the concrete has adequate drainage — either weep holes at the low end or a minimum 1 percent slope across the surface. Perfectly flat sealed concrete traps water under the gravel and creates a persistent damp layer.

Lay non-woven 4oz fabric over the concrete. Tape the edges to the concrete with exterior-grade tape to prevent lifting. Spread gravel directly on the fabric — no base layer needed since the concrete provides structural support. Minimum 2 inches of gravel depth to prevent fabric exposure at traffic points. Install edging around the perimeter as normal.

How to install pea gravel over existing gravel

Rake the existing gravel level and check the depth. If the existing layer is under 1.5 inches deep, add enough new gravel to bring the total to 2 to 3 inches. If the existing gravel has mixed with soil, the surface feels muddy when wet — this indicates the fabric has failed and the entire surface needs stripping, fabric replacement, and re-gravelling before any top-up.

How to install pea gravel around trees

Leave an 18-inch fabric-free zone around the base of any established tree. Landscape fabric under gravel reduces soil mycorrhizal fungi activity significantly over several years, limiting the tree's ability to absorb water and nutrients. Gravel can go up to the edge of this zone without fabric — the gravel layer alone suppresses most weeds adequately at that distance from the trunk.

How to install pea gravel around fence posts

Gravel against fence posts accelerates rot in wooden posts by trapping moisture against the wood. Keep pea gravel 4 to 6 inches away from wooden post bases. Use metal post bases or concrete collars where gravel contact is unavoidable. Steel and composite fence posts have no rot risk and can contact gravel without concern.

Advertisement

Time and Cost Estimates by Project Size

ProjectAreaDIY timePeople neededMaterial cost
Small garden path30 sq ft2–3 hours1$35–$65
Standard path (3×20 ft)60 sq ft3–4 hours1$70–$130
Small patio (10×10 ft)100 sq ft5–6 hours1–2$120–$220
Standard patio (12×14 ft)168 sq ft6–8 hours2$200–$370
Large patio (16×20 ft)320 sq ftFull weekend2$380–$700

Renting a plate compactor adds $65 to $85 but cuts compaction time by more than half on any project over 100 square feet. For projects above 200 square feet, the rental pays for itself in saved time. For small paths under 50 square feet, a hand tamper is sufficient and the rental isn't worth it.

For a full breakdown of pea gravel material costs including base stone, fabric, and edging, see the 2026 cost guide.

What People Get Wrong

Six mistakes that account for most pea gravel installation failures in the first season.

Using the wrong landscape fabric for the soil type
Every guide says "use landscape fabric." Almost none explains that woven fabric on clay soil creates a drainage problem over time, while non-woven fabric on sandy soil tears too easily under traffic. Match fabric type to soil type or you create a slow-developing problem that's expensive to fix.
Compacting the base layer all at once
Spreading 4 inches of crusher run and compacting it once produces a surface crust over a loose interior. That interior settles under foot traffic and creates depressions within one season. Two 2-inch compacted lifts take more time but produce genuine density throughout — the surface stays level for years.
Installing edging after the gravel goes down
Edging must go in before gravel. Installing it after means pulling gravel away from the edge, creating an irregular border, and failing to capture the fabric edge under the stake. The result looks unfinished and the edging never sits as securely as it would have with correct installation order.
Ordering unwashed pea gravel
Unwashed pea gravel contains clay fines that reduce drainage and create a muddy layer on the surface after rain. It also compacts poorly because the fine particles fill the void spaces between stones. Always specify washed 3/8-inch pea gravel. The price difference is minimal. The performance difference is real.
Skipping the drainage slope
A flat pea gravel patio or path has nowhere to drain. After heavy rain, water sits under the surface and gradually undermines the base layer. The surface develops soft spots and depressions that worsen with each rain cycle. A 1/4-inch drop per foot of run — established at excavation stage, not after — prevents this entirely.
Putting sand between clay and crushed stone
On clay soil, some installers add a sand layer between the clay and the crushed stone base, thinking it improves drainage. It does the opposite. Sand over clay creates a perched water table — water drains through the gravel and fabric, saturates the sand, and then cannot drain through the clay below fast enough. The sand layer stays permanently wet and eventually fails. Fabric directly on clay. Base stone directly on fabric. No sand.

Related Calculators

Related Guides

Was this guide helpful?

Frequently Asked Questions

How do you install pea gravel step by step?
Seven steps: calculate quantities, mark layout with drainage slope, excavate to depth and fix soft spots, lay landscape fabric (woven for sandy soil, non-woven for clay), spread and compact crushed stone base in 2-inch lifts, install edging staked every 2 feet, spread 3/8-inch washed pea gravel and rake level.
What do you put under pea gravel?
Two layers: landscape fabric directly on the excavated subgrade, and a crushed stone base (crusher run or #3 crushed stone) on top of the fabric. For decorative beds with no foot traffic, fabric alone is sufficient. For any path, patio, or driveway, both layers are necessary. The fabric prevents soil mixing upward into gravel. The crushed stone base provides structural support.
Do you need landscape fabric under pea gravel?
Yes for almost all applications. Fabric prevents the pea gravel from sinking into the soil over time through pumping — vehicle vibration and rainfall gradually push fine soil particles upward into the gravel, contaminating it and causing the surface to sink. Use woven 4oz fabric on sandy and loam soils. Use non-woven 4oz fabric on clay soils.
How deep should pea gravel be?
Decorative beds: 1 to 2 inches, no base. Garden paths: 2 inches of gravel over 1 to 2 inches of crushed stone. Patios: 3 inches of gravel over 2 inches of crushed stone. Driveways: 2 to 3 inches of gravel over 4 inches of compacted crushed stone base.
What is the best base for pea gravel?
Crusher run is the best base. It contains both large and fine particles that compact into a near-solid mass. Compact in 2-inch lifts with a plate compactor or hand tamper, moistening each lift lightly before compacting. Never use sand as a base under high-traffic surfaces — it shifts under load and allows the gravel to sink.
How do you install pea gravel on a slope?
On slopes up to 5 percent, standard installation with base and edging works. On slopes of 5 to 10 percent, add plastic honeycomb stabilization grids before spreading gravel. On slopes above 10 percent, pea gravel is unsuitable as a surface — use angular crusher run throughout. Measure slope by placing a 4-foot level horizontally and dividing the gap underneath (in inches) by 48, then multiplying by 100.
How do you install pea gravel over concrete?
First confirm the concrete surface drains — either weep holes at the low end or at least 1 percent slope. Lay non-woven 4oz fabric over the concrete and tape edges. Spread gravel directly on the fabric — no base layer needed since the concrete provides structure. Minimum 2 inches of gravel depth. Install edging around the perimeter as normal.
Do you need edging for pea gravel?
Yes. Pea gravel without perimeter edging scatters into adjacent lawn within weeks. Steel edging staked every 2 feet is the minimum. The edging top must sit at finished surface height so gravel sits 1/4 to 1/2 inch below it — edging set too low allows gravel to roll over it, too high creates a trip hazard.
How long does it take to install pea gravel?
A 100 square foot path takes 3 to 4 hours for one person. A 200 square foot patio takes 6 to 8 hours for two people. A 400 square foot patio takes a full weekend for two people. Add 1 hour for plate compactor setup on large areas. These estimates include all steps from excavation to final raking.
How do you install pea gravel on clay soil?
Use non-woven fabric rather than woven. Lay the fabric directly on the compacted clay — not on a sand layer, which would create a perched water table. Then add crushed stone base directly on the fabric. Non-woven fabric maintains drainage flow through clay pressure where woven fabric clogs over time.
How do you stop pea gravel from spreading?
Three simultaneous fixes: install or replace edging around the full perimeter staked every 2 feet, top up gravel to the full 2 to 3 inch depth, and rake monthly to push displaced gravel back from edges. If gravel still spreads despite edging, check that the edging top sits at or just above finished gravel surface level.
Can you install pea gravel without digging?
For decorative beds with no foot traffic, you can lay fabric on existing ground after removing surface vegetation, then spread 2 inches of gravel on top. For any path, patio, or driveway, proper excavation is not optional. Without removing soil to depth and installing a compacted base, the surface sinks and develops ruts within one season regardless of gravel depth.
What size pea gravel is best for installation?
3/8-inch washed pea gravel works for most installations — large enough to stay in place under normal traffic, small enough to feel comfortable underfoot, and the most widely available grade. Specify washed material. Unwashed pea gravel contains clay fines that reduce drainage and pack poorly. For barefoot areas and playgrounds, 1/4-inch is softer underfoot but displaces more easily.
